Hoe de Mylopotamos school werd afgebouwd. Overgenomen uit de in het Engels geschreven 3-maandelijkse werkrapporten van het Team.
*Click on the text to enlarge

Road work Agia Pelagia towards Karavas
*Click on a photo to enlarge
1970 July 1st (April, May, June)

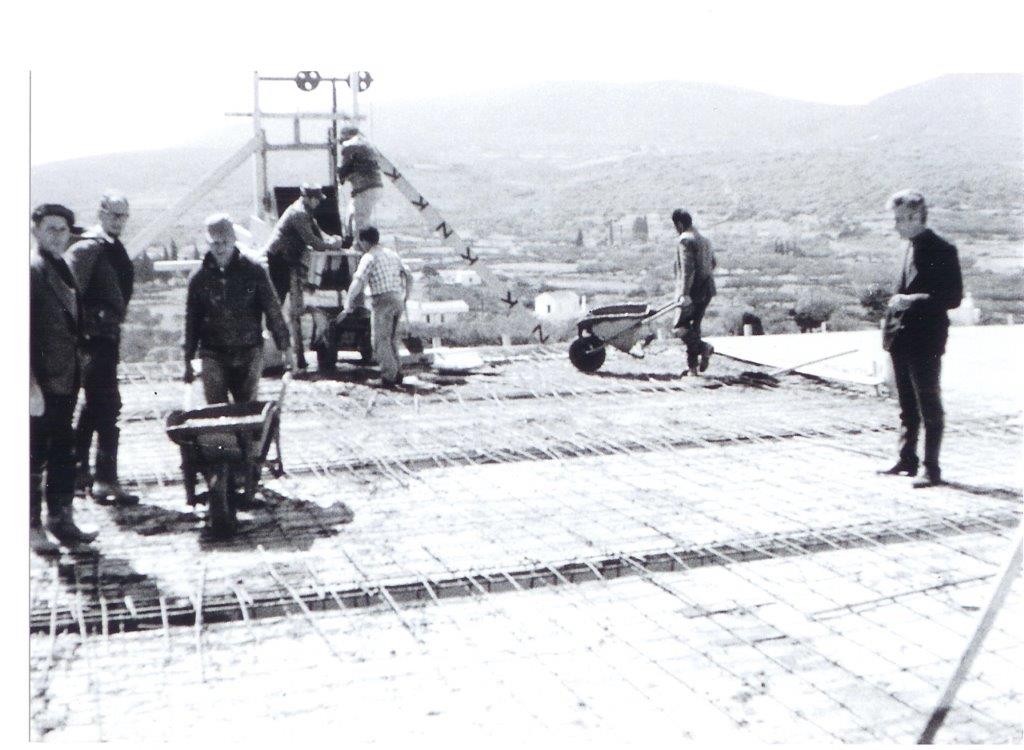

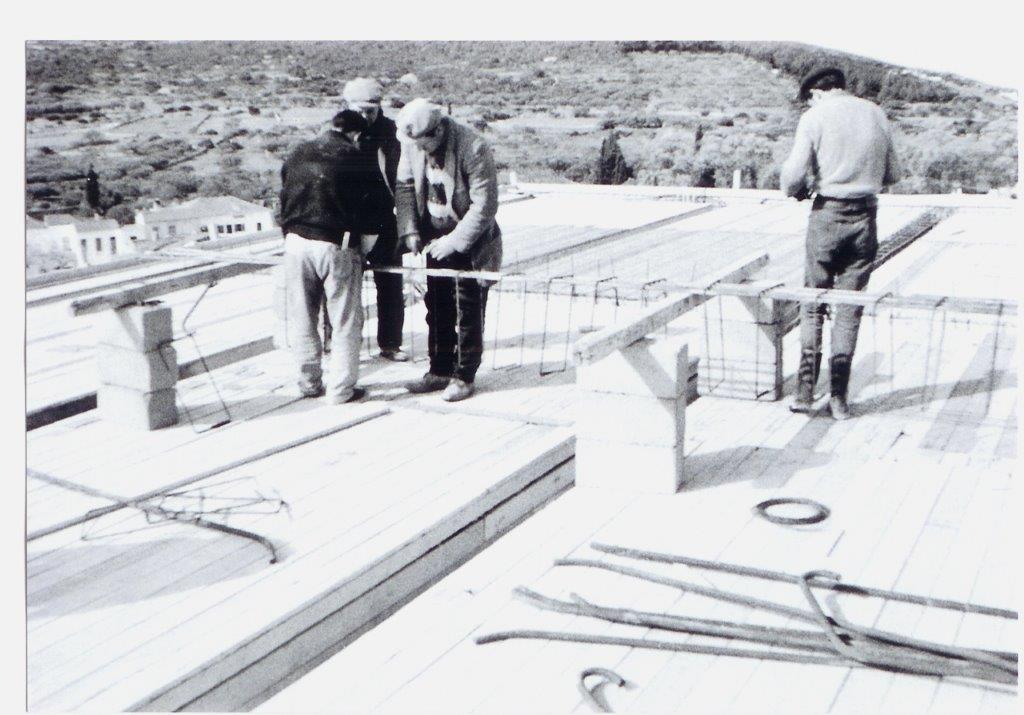

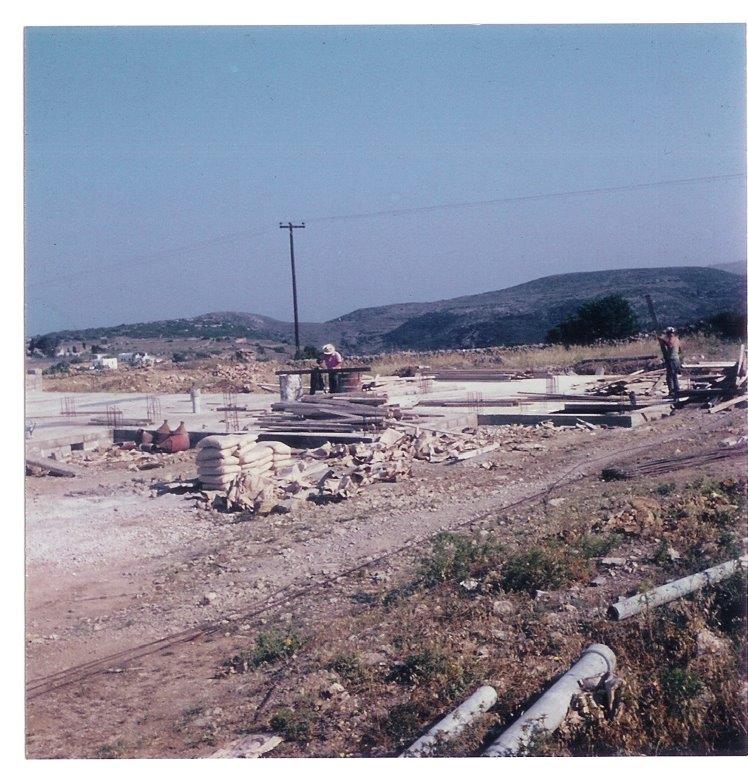

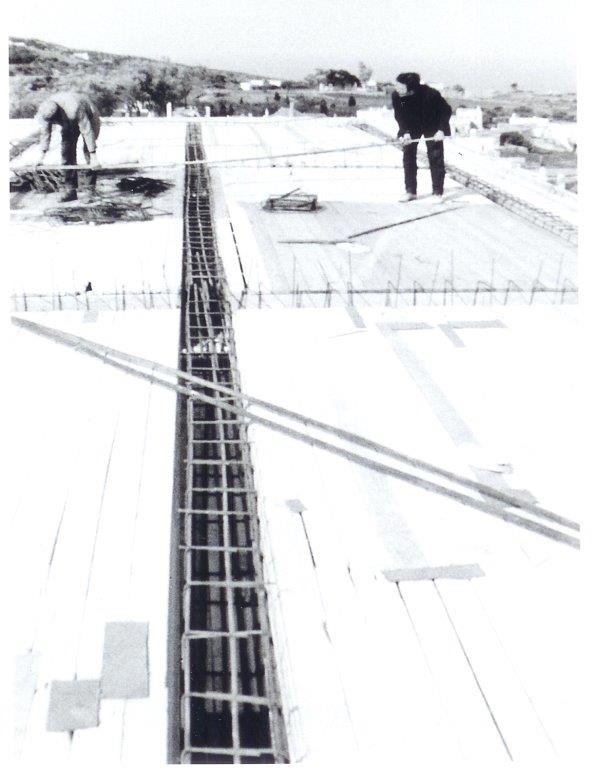

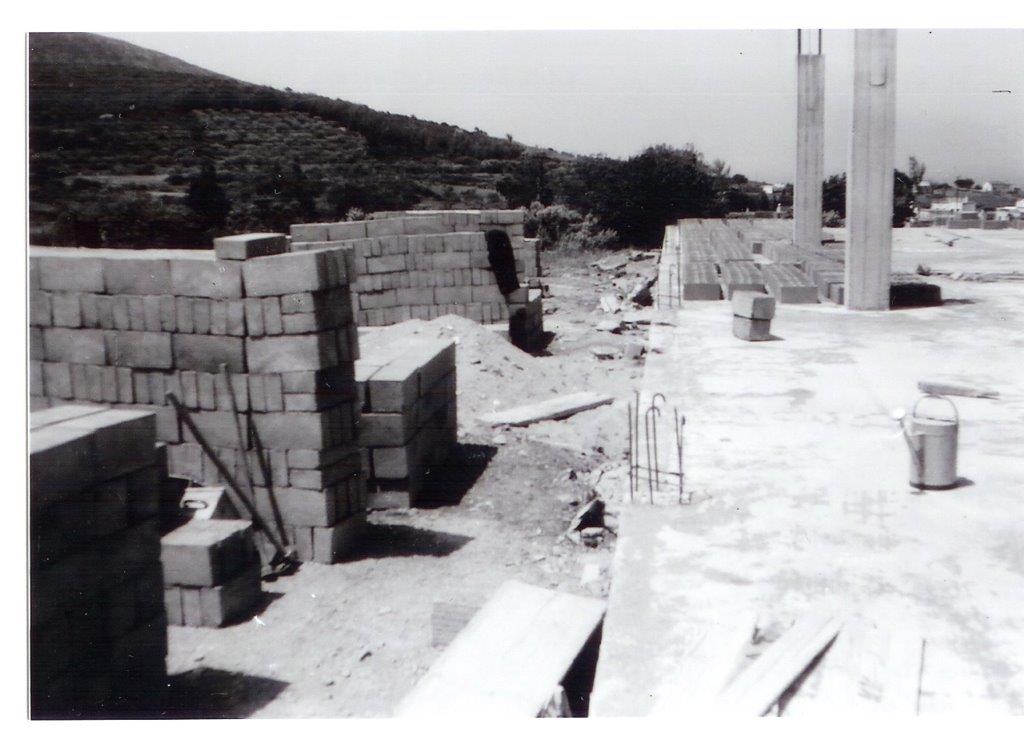

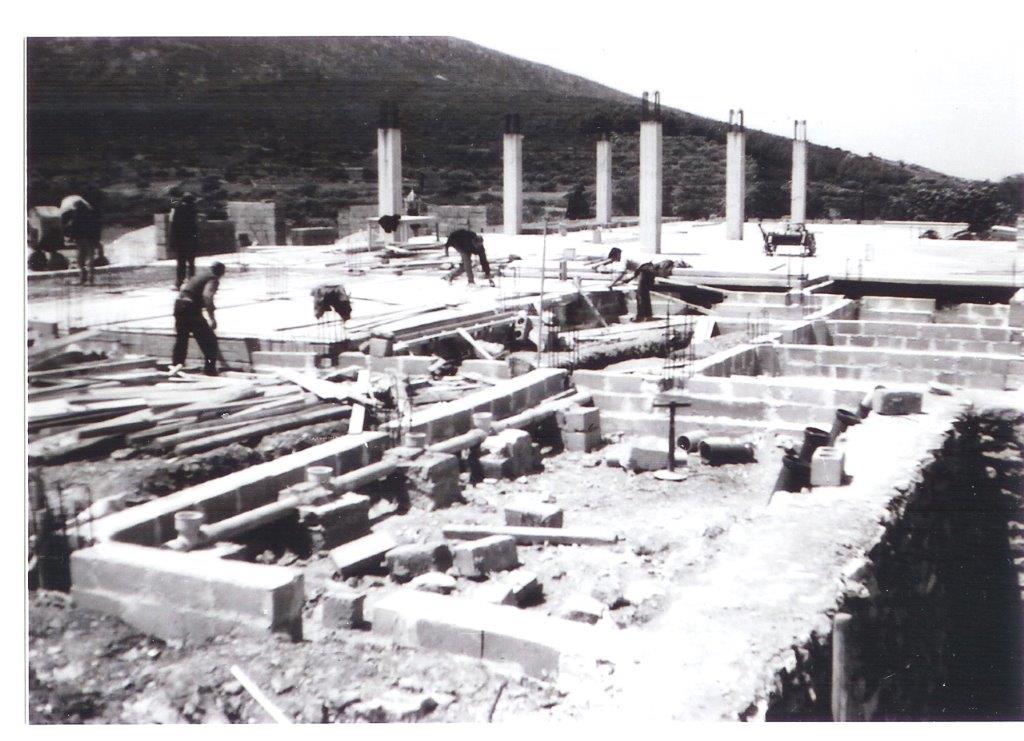

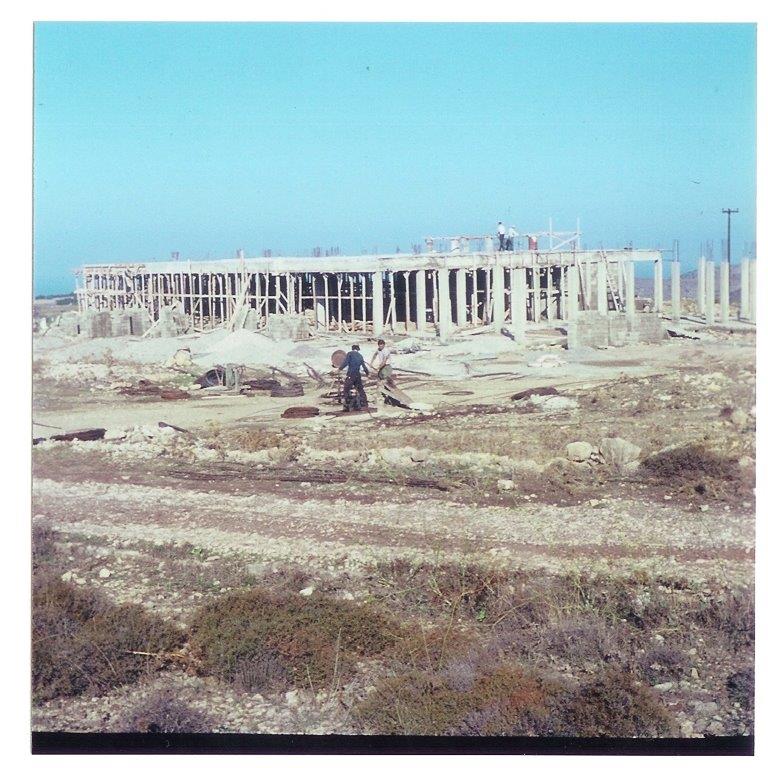

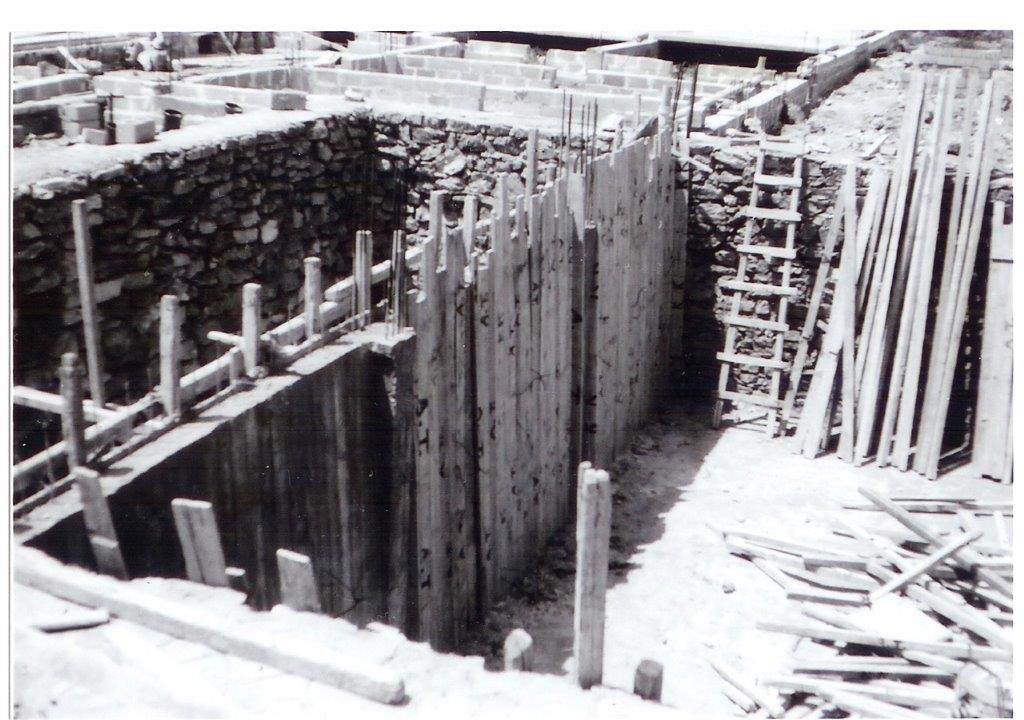

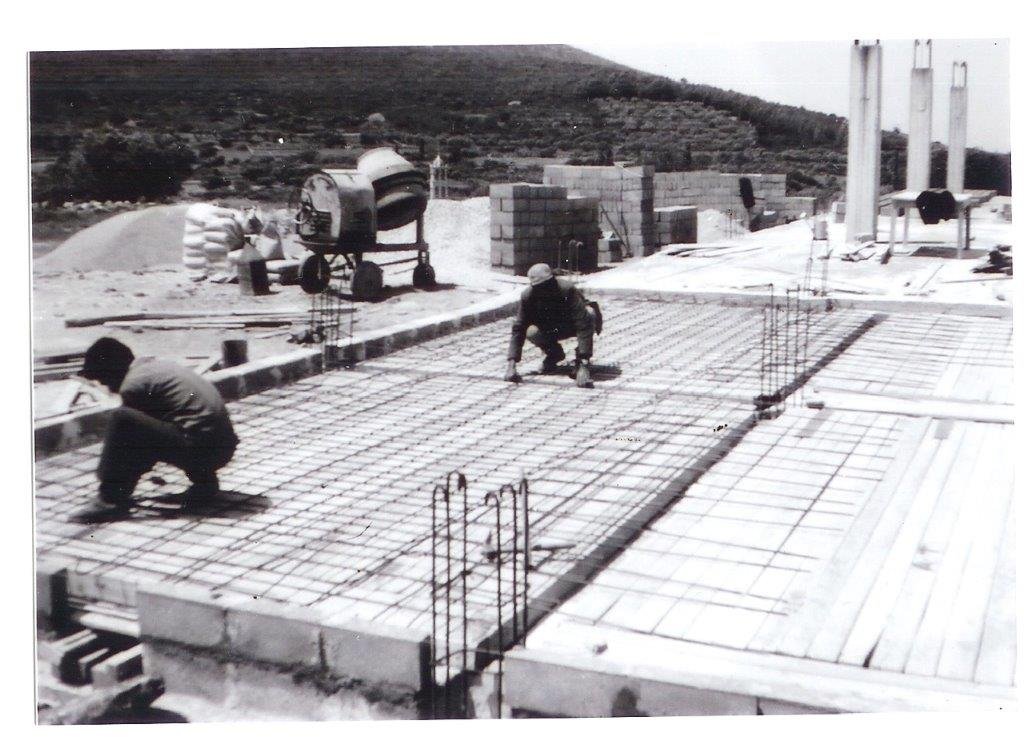

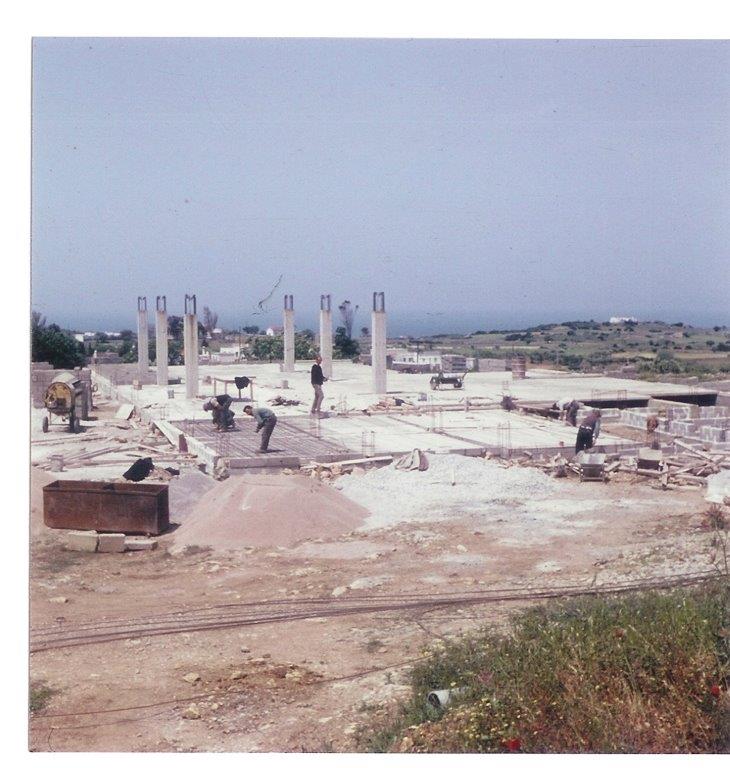

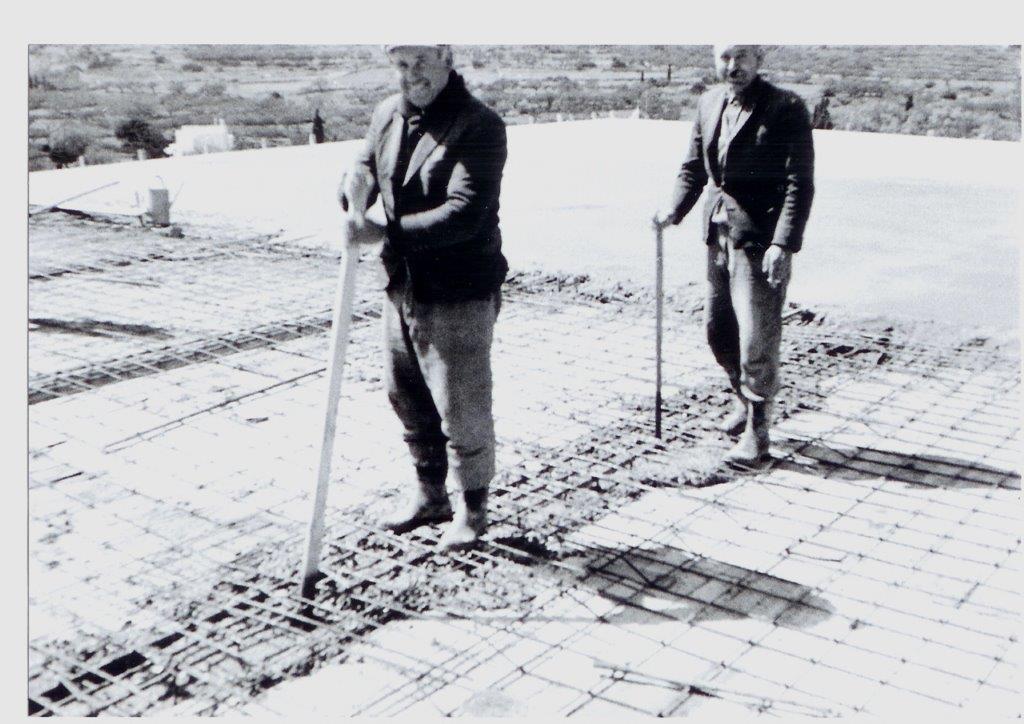

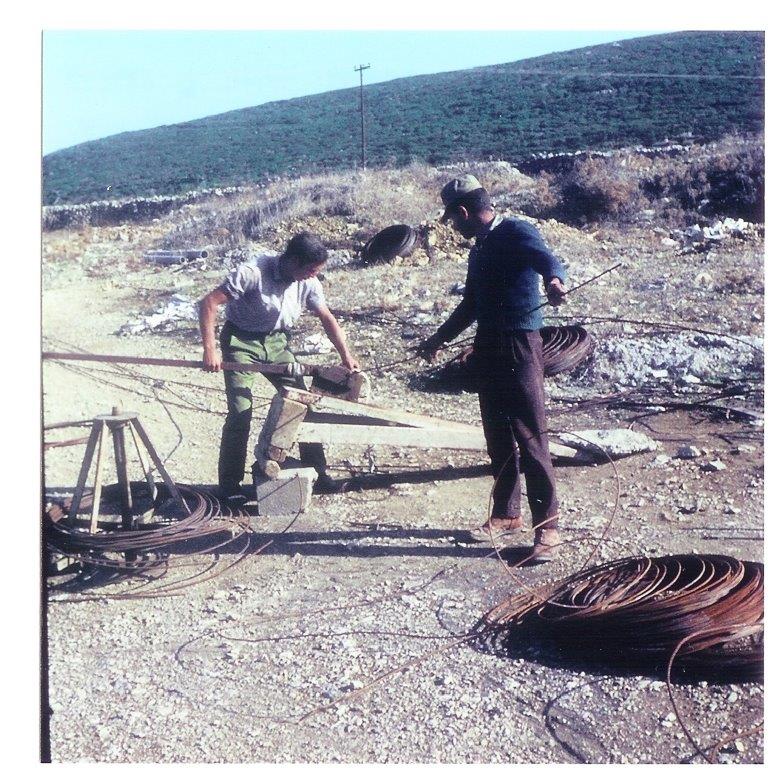

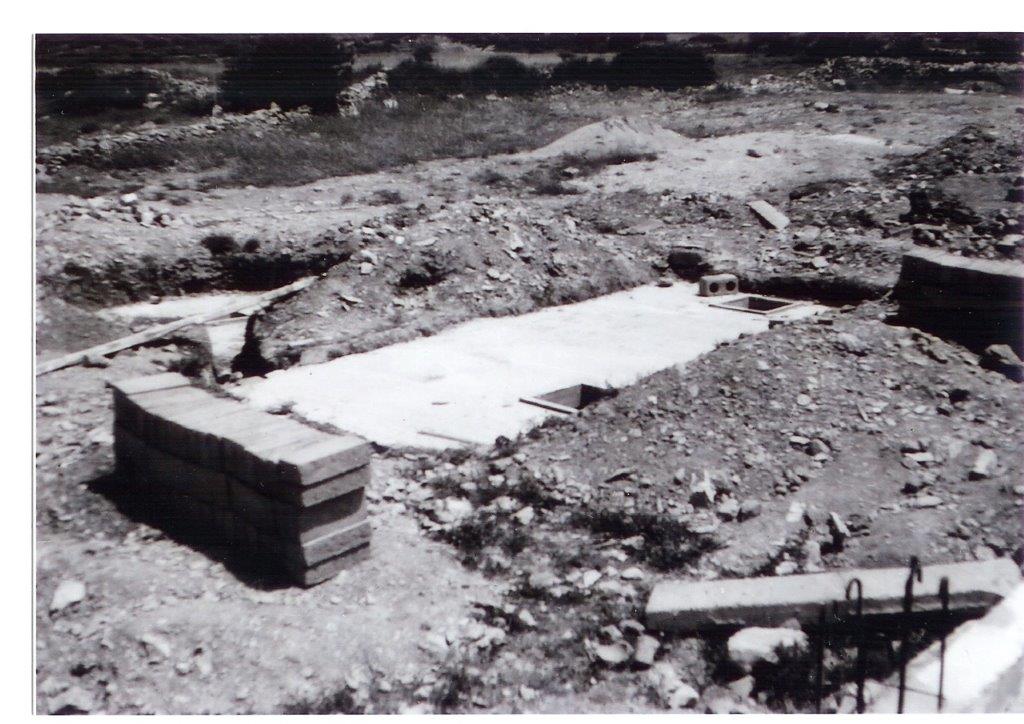

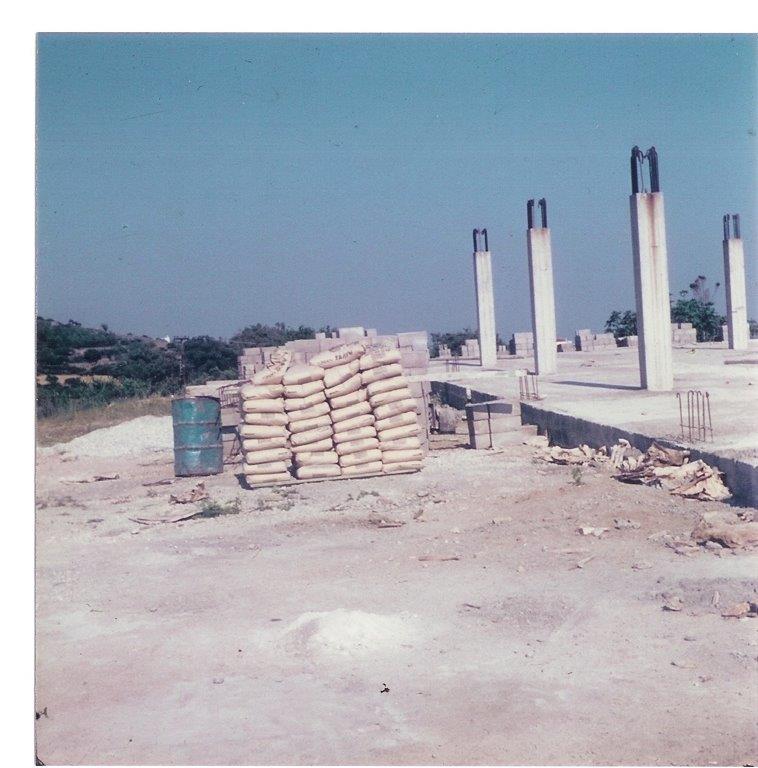

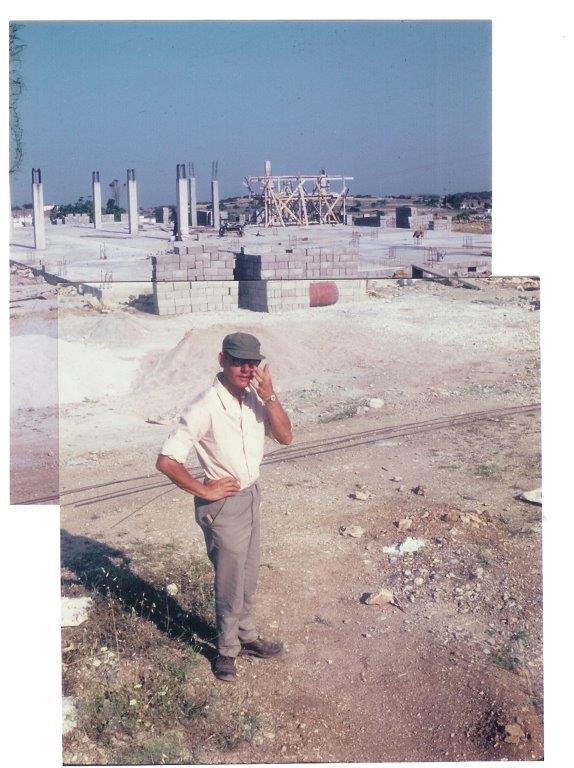

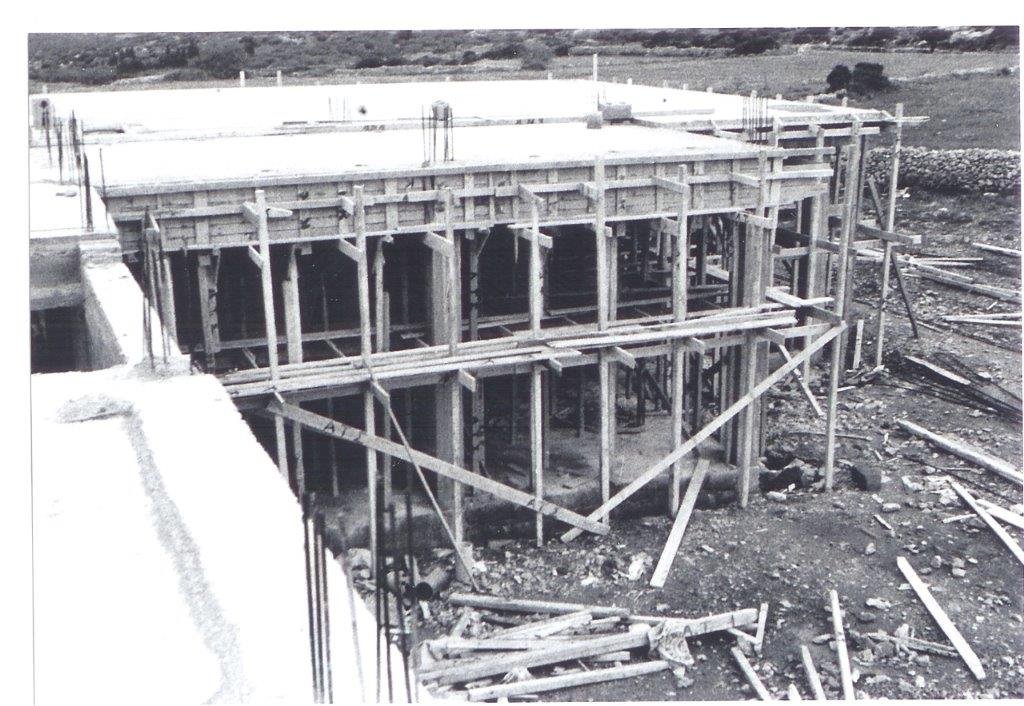

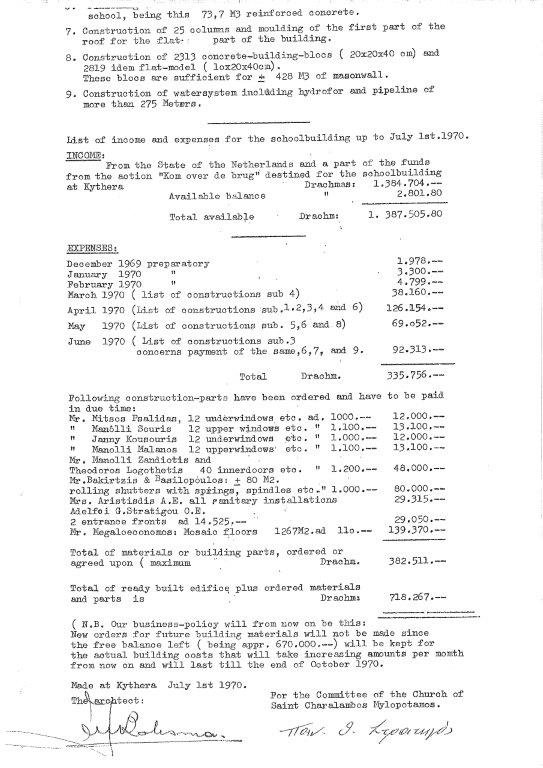

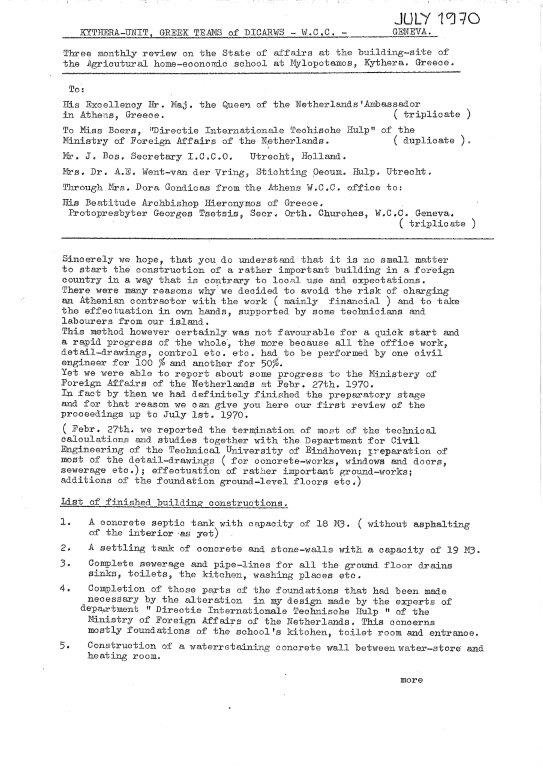

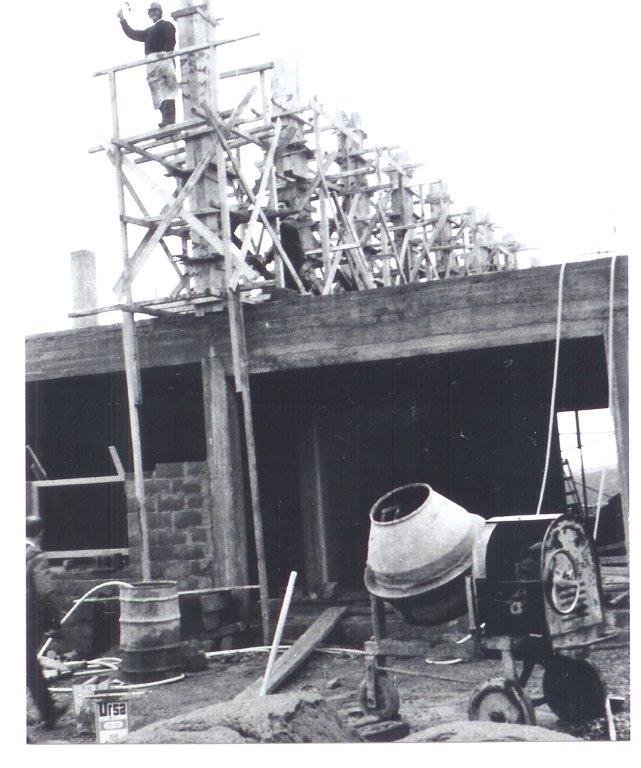

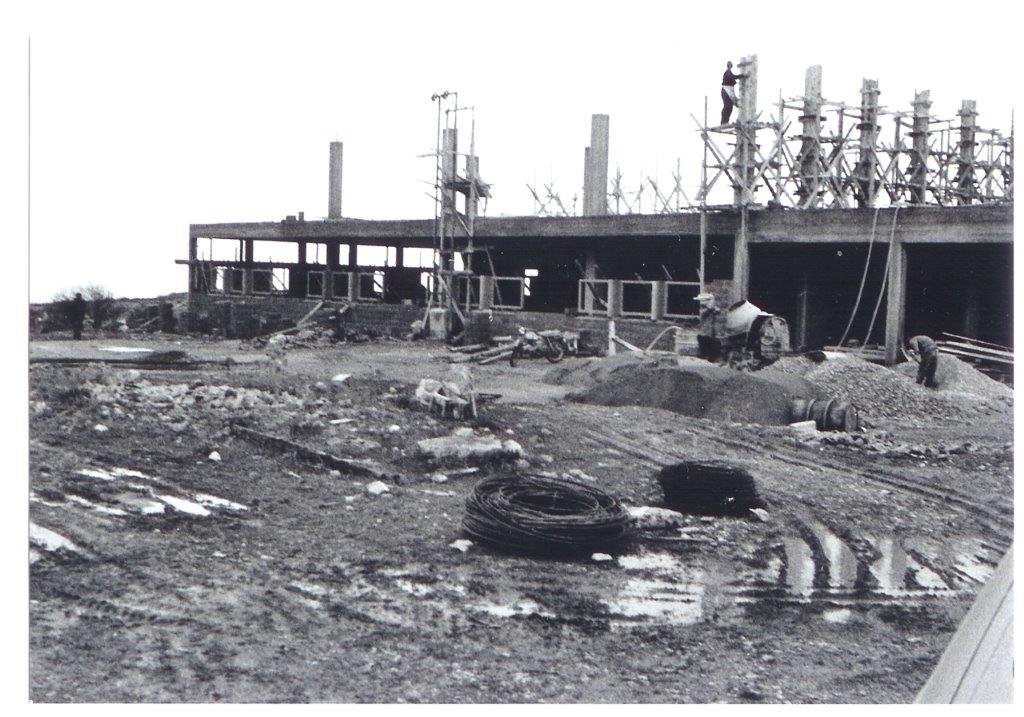

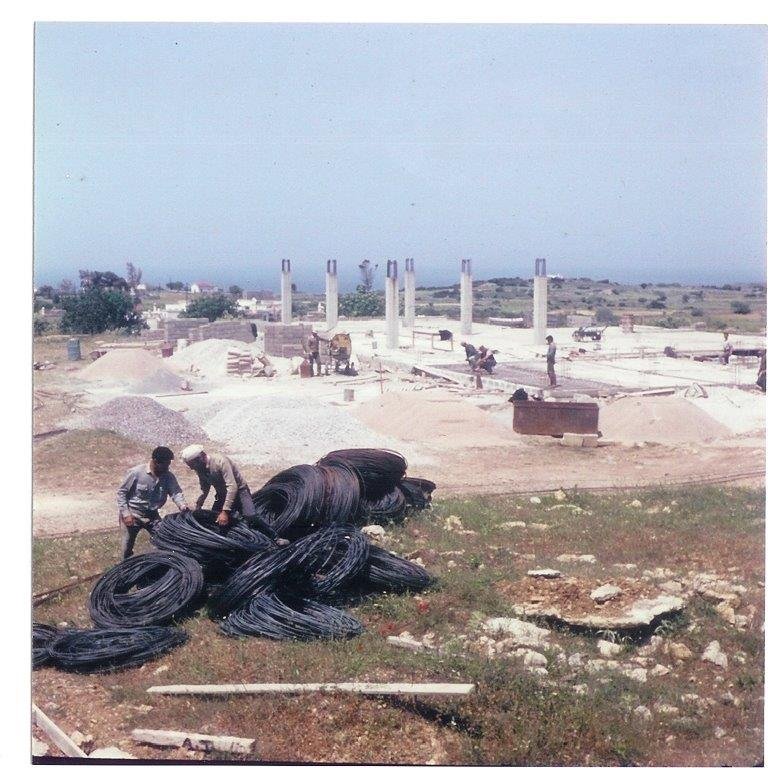

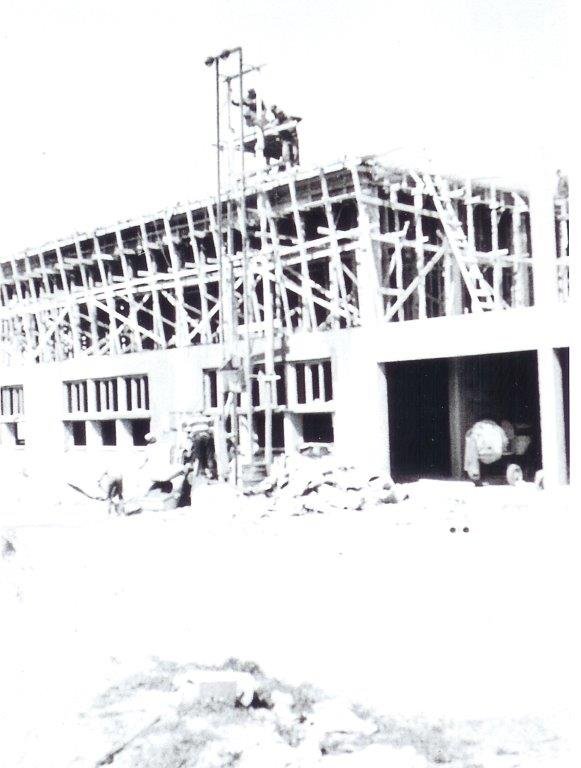

Status of school construction in Mylopotamos: cellar of 200 m3, septic tank 19 m3, settling tank 19 m3 and ground floor with masonry are finished. Construction of irrigation water system in Mylopotamos on its way.
